Most projects do not exist in a
Reasons that you might need to create dependencies between projects include the following:
The completion of one task in a project might enable the start of a task in another project. For example, another project manager might need to complete an environmental impact statement before you can start to construct a building. Even if these two tasks are managed in separate project plans (perhaps because separate departments of a development company are completing them), one project has a logical dependency on the other.
A person or a piece of equipment might be assigned to a task in one project, and you need to delay the start of a task in another project until that resource completes the first task. The two tasks might have nothing in common other than needing that resource.
Task relationships between project plans look similar to links between tasks within a project plan, except that external predecessor and successor tasks have gray task
In this exercise, you link tasks in two project plans, and you see the results in the two project plans, as well as in a consolidated project plan.
On the Window menu, click Parnell Aerospace Promo 20 .
In the
Task
On the Standard toolbar, click the Go To Selected Task button.
To the right of the task’s Gantt bar, one of the resources assigned to this task is named Fabrikam Inc. Sound Studio. You want to use this studio for work on the Wingtip Toys project after this task is completed.
On the Window menu, click Wingtip Toys Commercial 20 .
On the View menu, click Gantt Chart .
Click the name of task 5, Fine cut edit .
On the Standard toolbar, click the Go To Selected Task button.
Project
On the Standard toolbar, click the Task Information button.
The Task Information dialog box appears. In the next two steps you will enter the file name and task ID of the predecessor task in this format: File Name\Task ID.
Click the Predecessors tab.
In the
ID
column, click the next empty
Press the [Enter] key, and then click OK to close the Task Information dialog box.
Project
| Tip |

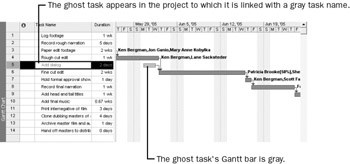

If you point to the ghost task’s Gantt bar, Project displays a ScreenTip that contains details about the ghost task, including the full
|
Next you’ll look at the ghost task in the Parnell project.
On the Window menu, click Parnell Aerospace Promo 20 .
Here you can see that ghost task 9, Fine cut edit, is a successor for task 8, Add dialog. Because task 9 is a successor task with no other links to this project, it has no effect on other tasks here.
The link between these two project plans will
To conclude this exercise, you will display the link between these two projects in the consolidated project plan.
On the Window menu, click Consolidated Projects 20 .

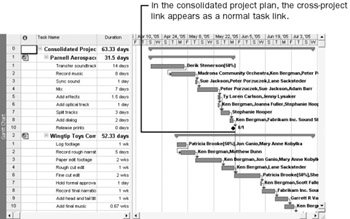

You can see the link line between the task Add dialog in the first inserted project and the task Fine cut edit in the second inserted project.
Your screen should look similar to the following illustration:
Because you are looking at a consolidated project plan that shows the tasks from both project plans, the cross-project link does not appear as a ghost task.
Here are a few more tips and suggestions for working with consolidated projects and cross-project links:
If you do not want to see cross-project links, on the Tools menu, click Options . On the View tab, clear the Show external successors or Show external predecessors check box.
When viewing a consolidated project, you can quickly create cross-project links by clicking the Link Tasks button on the Standard toolbar. Dragging the mouse between two task bars will do the same thing.
Each time you
